Overview of court installation sub-base and surfacing layers

From Dirt to Dunks: A Guide to Professional Sports Court Installation

Key Benefits and Surface Options for Commercial Athletic Court Installation

Selecting the proper surface during an athletic court installation project is one of the most critical decisions a facility manager or athletic director can make. A well-engineered commercial sports floor delivers a strong return on investment (ROI) by maximizing facility usage, reducing long-term maintenance costs, and attracting high-caliber sports programs and tournaments.

Different surface systems offer distinct performance characteristics, maintenance needs, and life cycles. Understanding how these systems compare allows commercial facilities to make informed purchasing choices.

Surface Type Primary Commercial Applications Key Shock Absorption & Safety Maintenance Level Relative Lifespan
Post-Tensioned Concrete / Hard Court Outdoor basketball, tennis, multipurpose complexes Firm ball bounce; low impact attenuation Low; periodic crack inspection 20+ years
Acrylic Coatings Outdoor tennis, pickleball, track perimeters Moderate traction; minimal impact absorption Medium; resurfacing every 4–7 years 10–15 years
Modular Tiles Indoor/outdoor multi-sport, volleyball, basketball Built-in lateral forgiveness and vertical shock absorption Very Low; individual tile replacement 15–20+ years
Synthetic Turf Indoor fieldhouses, agility training, multi-sport facilities High impact cushioning; reduces joint fatigue Low to Medium; periodic brushing 8–12 years
Hardwood Flooring Systems High-school, collegiate, and professional indoor gyms Exceptional spring, uniform bounce, top-tier shock absorption High; annual recoating, sanding every 10–12 years 38+ years

To explore indoor and outdoor facility options in greater detail, see our guide on From gyms to courts: uncovering the best athletic flooring solutions.

Selecting Surfaces for Multi-Sport Commercial Athletic Court Installation

Commercial sports facilities often need to maximize indoor or outdoor square footage by hosting multiple sports on a single surface. Modern multi-sport athletic court installation accommodates basketball, pickleball, volleyball, and indoor soccer on one footprint using color-coded game striping.

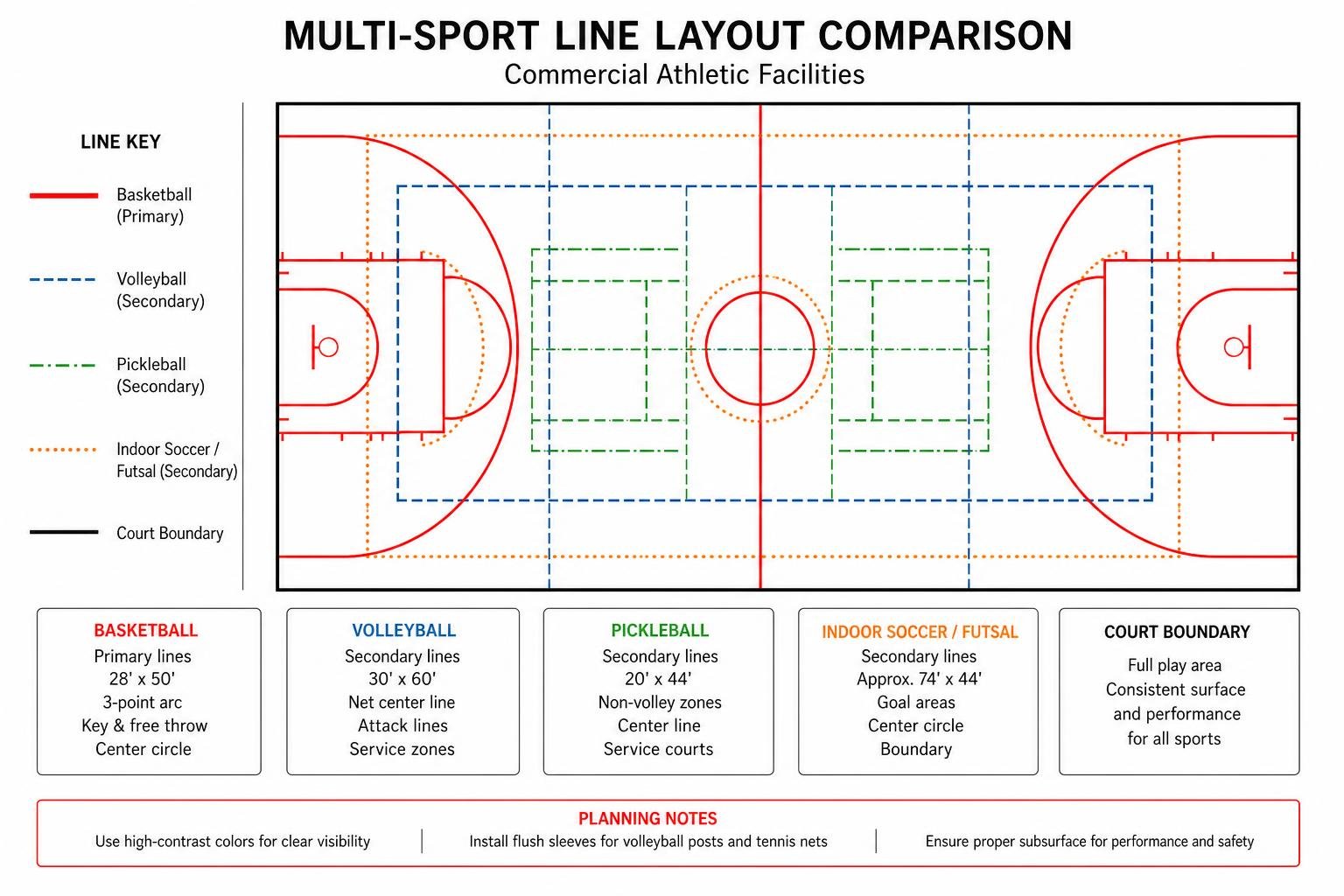

Multi-sport line layout comparison for commercial athletic facilities

When planning a multi-use layout:

  • Primary vs. Secondary Markings: Use distinct, high-contrast paint colors for primary lines (such as main basketball boundaries) and secondary lines (such as pickleball or volleyball courts).
  • Subsurface Elasticity: Ensure the surface system provides uniform ball rebound for basketballs while maintaining adequate traction for rapid lateral movements in pickleball or tennis.
  • Accessory Sleeves: Install flush floor sleeves for volleyball posts and tennis nets before pouring concrete or laying synthetic underlayment.

For further insights on choosing the optimal surface for court sports, read our analysis on Choosing your court: the best basketball flooring options.

Safety Features and Shock Absorption Requirements

In commercial and institutional athletics, athlete protection is paramount. Hard, unyielding surfaces contribute to impact injuries, lower-body stress fractures, and joint fatigue over time.

Prioritize these safety features in commercial court design:

  • Shock Absorption (Force Reduction): Surface systems engineered with rubber underlayments or suspended interlocking structures absorb vertical kinetic energy, protecting knees, ankles, and lower backs.
  • Lateral Forgiveness: Advanced modular surfaces offer microscopic movement between interlocks, absorbing side-to-side stopping forces and reducing rotational stress on joints.
  • Perimeter Safety & Lighting: High-lumen LED lighting eliminates shadow zones across the playing area, while perimeter containment fencing or padded wall mats protect players running out of bounds.

Planning and Site Preparation for Sports Facilities

A high-performance surface relies on a solid, carefully prepared base. Skipping base preparation can cause premature surface failure, pooling water, and structural cracking.

Site preparation involves several key stages:

  1. Soil Testing and Excavation: Geotechnical engineers evaluate soil composition to check load-bearing capacity and expansion potential.
  2. Sub-Base Stabilization: Soil is excavated to the required depth, compacted, and reinforced with aggregate base materials.
  3. Laser Grading: Precision laser equipment grades the sub-base to establish uniform slope tolerances for drainage.
  4. Slab Pouring and Curing: Post-tensioned or reinforced concrete pads are poured. Standard concrete requires a curing period of 28 days to outgas moisture completely before applying coatings or top surfaces.
  5. Permitting and Compliance: Commercial sites must comply with local building codes, municipal stormwater regulations, and ADA accessibility standards.

For more information on facility-specific planning, read How to find the best athletic court flooring for your space.

Regional Climate and Soil Conditions in Court Construction

Regional weather patterns dictate sub-base engineering and surface selection across Ohio, Indiana, Kentucky, and West Virginia:

  • Freeze-Thaw Cycles: Regions experiencing freezing winter temperatures require non-expansive gravel sub-bases and frost-line footing depths to prevent winter heave from cracking concrete slabs.
  • Expansive Clay Soils: Soils rich in clay expand when wet and contract during dry summer spells. Post-tensioned concrete slabs use high-strength steel tendons pulled under tension to counteract continuous soil movement.
  • Drainage and Weatherproofing: Outdoor commercial surfaces must feature a 1% slope gradient paired with sub-surface drainage pipes, swales, or catch basins to divert runoff away from the playing surface.

Choosing Specialized Contractors for Professional Athletic Court Installation

Executing a commercial athletic court project requires specialized construction expertise. Working with general contractors who lack specific sports-surface experience can lead to improper moisture mitigation, incorrect line dimensions, or voided material warranties.

When vetting court builders, look for:

  • Extensive industry experience and proven commercial portfolios.
  • Turn-key management capabilities covering excavation, concrete work, surfacing, line striping, and accessory setup.
  • Active bonding, licensing, and comprehensive liability insurance.
  • Direct certifications from leading athletic flooring manufacturers.

Learn how to select qualified installation partners in our guide: How to find athletic court specialists who won’t drop the ball.

Cost, Timeline, and Installation Workflow

Understanding project timelines and cost factors helps facility directors schedule construction around sports seasons and minimize operational downtime.

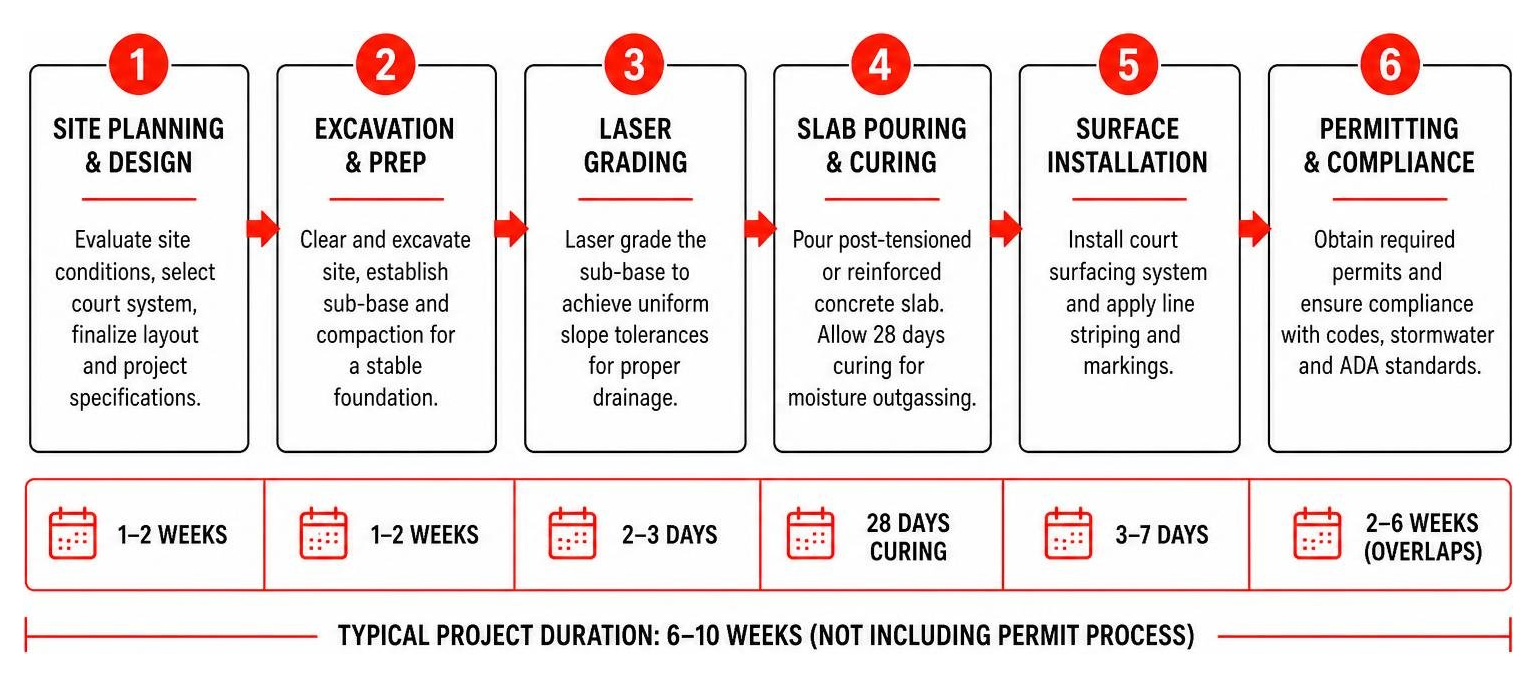

Commercial athletic court project timeline breakdown

Key factors influencing project investment include:

  • Total Footprint: Square footage directly drives material volume, sub-base excavation, and labor demands.
  • Site Accessibility: Tight indoor spaces or restricted outdoor sites requiring specialized earthmoving equipment increase overall labor hours.
  • Accessories & Upgrades: Integrated post sleeves, high-output LED lighting poles, chain-link containment fencing, wall padding, and custom center-court logos add to the base installation cost.

Commercial court installation project in progress

Modular Surface Systems vs Traditional Concrete Courts

Facilities often weigh modular open-grid surface tiles against traditional post-tensioned concrete or acrylic hard courts.

  • Modular Tile Systems: Interlocking tiles sit above a concrete slab. They feature open grids that allow rainwater to drain immediately, eliminating standing puddles. They provide excellent lateral forgiveness, feature lower long-term maintenance costs, and permit fast individual tile replacement if damage occurs.
  • Post-Tensioned Concrete Courts: These systems provide a permanent, ultra-durable slab resistant to soil-induced cracking. However, acrylic coatings applied directly to concrete require recoating every 4 to 7 years to fix wear, fading, and micro-fissures.

Compare performance systems further in Beyond the baseline: exploring high-performance athletic flooring solutions.

Maintenance Strategies for Institutional Facilities

Proactive facility maintenance prolongs court life, maintains proper traction, and keeps manufacturer warranties active.

Establish a preventive maintenance schedule based on surface type:

  • Indoor Hardwood Facilities: Daily dust mopping, weekly automatic scrubbing with manufacturer-approved cleaning agents, annual protective finish recoating, and complete sanding/refinishing every 10 to 12 years.
  • Acrylic Outdoor Courts: Monthly pressure washing or power sweeping to clear debris, routine cleaning of perimeter drainage structures, and scheduled acrylic resurfacing every 4 to 7 years.
  • Modular Tile Courts: Periodic debris blowing, low-pressure washing to clear dust from grid voids, and regular visual inspections of interlock tabs and expansion joints.

Schedule professional service through our team for expert court care and Gym floor installation.

Frequently Asked Questions About Commercial Court Building

What is the typical construction timeline for an institutional sports court?

A complete outdoor commercial construction project usually takes 6 to 10 weeks from initial site excavation to final game line curing. This includes 1 to 2 weeks for site prep and concrete placement, a mandatory 28-day curing period for new concrete, and 1 to 2 weeks for surfacing, accessory installation, and painting. Indoor synthetic or wood installations generally take 2 to 4 weeks once subfloor conditions pass moisture tests.

How do climate and soil stability affect long-term court durability?

Expansive clay soils and severe winter freeze-thaw cycles exert dynamic forces on court foundations. Unstable soil can cause standard asphalt or reinforced concrete to crack, buckle, and shift out of level. Installing post-tensioned concrete slabs over stabilized, well-drained aggregate sub-bases protects structural integrity and prevents water pooling under the surface.

What safety standards should commercial athletic courts meet?

Commercial courts must meet established shock absorption (ASTM F2772 for indoor synthetic/wood floors) and slip-resistance metrics. These standards ensure predictable ball response while delivering force reduction levels between 22% and 50%+, mitigating impact stress on athletes’ lower limbs.

Conclusion

Planning a commercial athletic court installation requires balancing facility goals, surface engineering, site conditions, and long-term maintenance budgets. Selecting the right base design and shock-absorbing playing surface allows schools, universities, and commercial sports facilities to build venues that protect athletes and perform reliably year after year.

Our team at The Final Floor brings expert project management, quality materials, and dedicated installation crews to every commercial facility build across Ohio, Indiana, Kentucky, and West Virginia. Explore commercial athletic flooring solutions today or contact us to schedule a free project consultation.
